Carpark Leak Remediation – Southbank

Waterproofing

Southbank, VIC

2024

Project Details

Client Type:

Owners Corporation

Location:

Southbank, VIC

Duration:

8 weeks

Defect Type:

Waterproofing

Year Completed:

2024

What We Managed

We successfully managed the remediation of a common podium courtyard as well as the nearby planter boxes causing water ingress into the below carpark basement. Our structured approach ensured proper diagnosis and long-term waterproofing solutions.

The project involved coordinating multiple stakeholders while keeping the common gym operational during works, requiring careful staging and access management.

Leak Investigation

Identified the source of water ingress and developed a targeted remediation plan.

Project Coordination

Managed planning, remedial engineering design, scope of works, contractor tendering, and compliance from start to finish.

Waterproofing & Repairs

Removed large trees from planter boxes, removed old bitumen waterproofing, created proper falls, installed high-quality waterproofing to podium and planter boxes, and reinstated planter boxes with soil for landscaping.

Final Inspection

Verified waterproofing effectiveness and completed defects checks.

The Challenge

[2-3 paragraphs describing the problem – use existing content from current site]

Example for Carpark project:

We successfully managed the remediation of a common podium courtyard as well as the nearby planter boxes causing water ingress into the below carpark basement. Our structured approach ensured proper diagnosis and long-term waterproofing solutions.

The project involved coordinating multiple stakeholders while keeping the common gym operational during works, requiring careful staging and access management.

Challenges & Solutions

Every project presents unique obstacles. Here’s how we tackled the key challenges on this remediation project.
ChallengeChallenge DescriptionOur Solution
Uncovering Hidden Issues

Original waterproofing was bitumen and had to be ground back. Issue with glazing channel where pool glazing windows are located. Common gym remained open during works.

Introduced a hob to allow drainage and minimize risk for the glazing channel. Introduced other modifications once further unknowns were discovered. Leak detection system was installed to identify any compromises before pod/pavers and soil was installed.

Minimizing Disruptions

Scheduled works efficiently to maintain residence access while keeping facilities operational.

Staged works carefully to maintain resident access throughout. Coordinated with facility management to keep gym operational during remediation.

Ensuring Durability

Need for long-term protection and early warning system for future issues.

Premium waterproofing solutions with 20-year warranty. Leak detection installed to easily detect any future compromises, which can be repaired immediately.

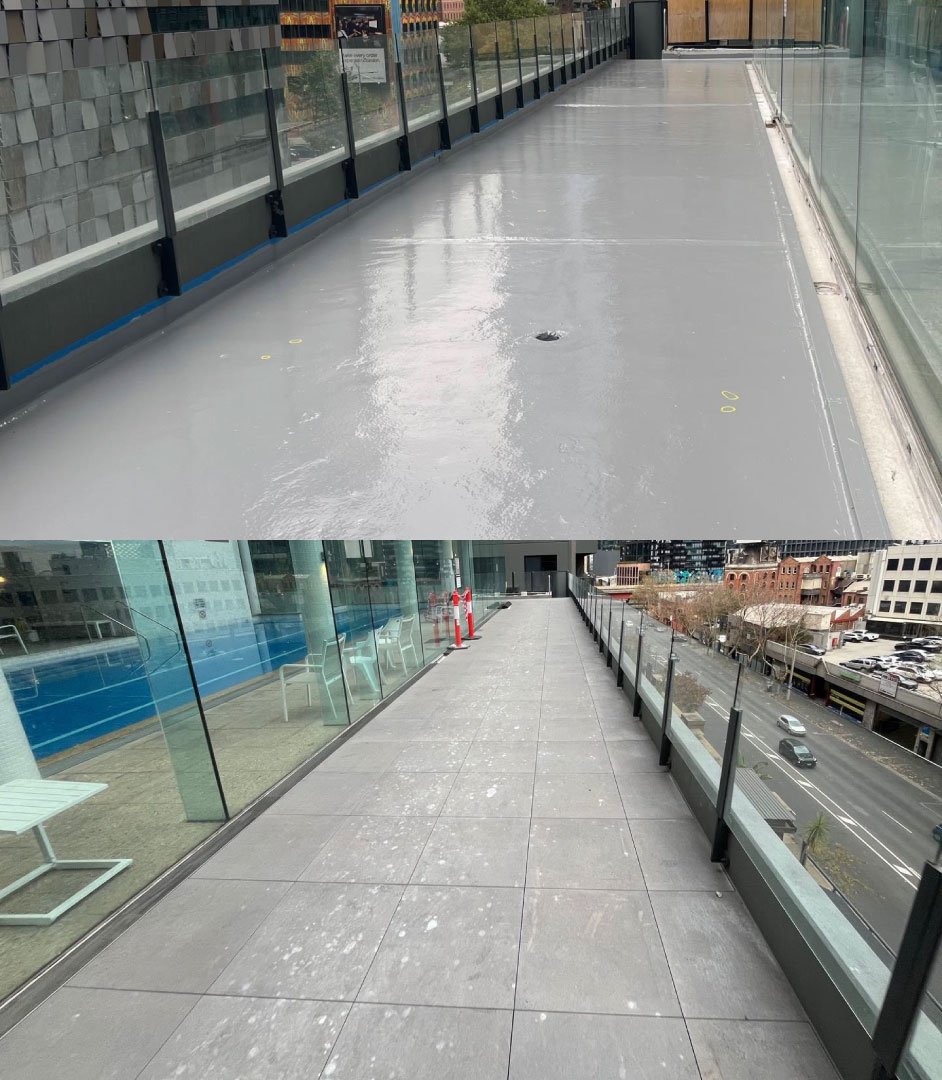

Project Gallery

Visual documentation of our work from initial assessment through to project completion.

Similar Projects

Explore more of our waterproofing and remediation work.

Have a Similar Issue?

Request a project assessment, and we’ll evaluate your waterproofing defect, explain the remediation process, and provide a clear path to compliance.
